Possession is the question every FT2 buyer eventually asks and the honest answer varies significantly depending on which sector you bought in. Sector O in the Model Block is the only part of Faisal Town Phase 2 currently at semi-possession stage, where buyers with completed payments can begin construction now. Every other sector is at an earlier stage, with timelines that depend on infrastructure completion rather than any fixed date. This blog covers what possession actually means in the context of this project, where each sector stands as of mid-2026, what the developer has officially said about timelines, and how possession relates to but is separate from the project’s NOC status.
What “Possession” Actually Means in Faisal Town Phase 2
Most buyers use the word “possession” without knowing what it specifically means in a developing housing society and the answer matters before you compare sectors. In Faisal Town Phase 2, possession means the developer has formally handed over a plot to the buyer, confirming that the infrastructure around it is sufficiently complete to allow construction to begin. It does not mean a finished house, a connected utility meter, or a street with functioning streetlights. It means the land is yours to build on.
Semi-possession is a stage before full possession infrastructure is in place and construction can start in practice, but the formal full possession process may not be complete for every plot in that sector. Sector O is currently at this stage.
| Term | What It Means in FT2 |
| Semi-possession | Infrastructure in place, construction can begin, formal handover in progress |
| Full possession | Formal handover complete, plot confirmed with demarcation on ground |
| Development stage | Roads, utilities or groundwork still underway construction not yet possible |
| Pre-launch / early stage | Planning or early groundwork only possession is years away |
Overall Development Status Where the Project Stands Right Now
Before looking at individual sectors, here’s the project-wide picture as of mid-2026 the confirmed on-ground position across all of Faisal Town Phase 2.
| Development Feature | Current Status |
| Land levelling | 80–90% complete across the project |
| Main 350-foot boulevard | Under construction paving in final stages |
| Internal roads | Being laid across sectors at different stages |
| Underground utilities | Work commenced electricity and drainage underway |
| Community facilities | Foundation work for mosques and parks underway |
| Heavy machinery on site | Approximately 600 machines actively working |
| Developer completion target | Less than 4 years from announcement |
| Model Block possession target | 1 to 1.5 years (as stated by Chairman Chaudhry Abdul Majeed) |
This project-wide picture shows meaningful progress but it also shows that most of the work is still ongoing. 80–90% land levelling being complete does not mean 80–90% of the project is possession-ready. Land levelling is the earliest infrastructure stage. Roads, utilities, plot demarcation, and formal handover all come after it.

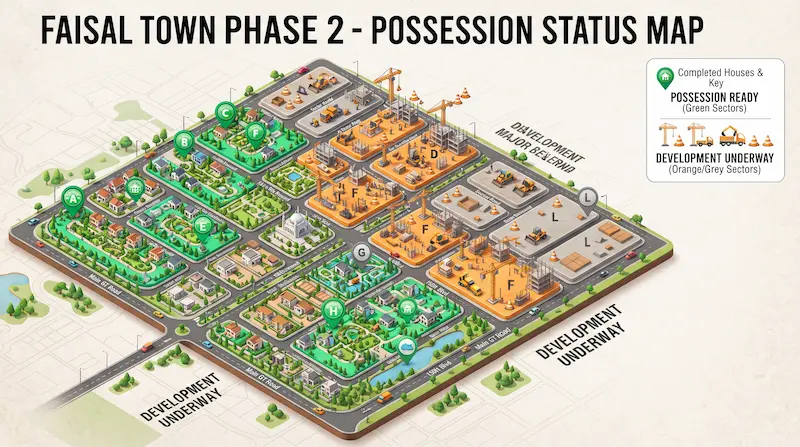

Sector-by-Sector Possession Status The Honest Picture
No competitor page breaks possession status down sector by sector. The table below does exactly that every major zone in Faisal Town Phase 2 with its confirmed current status as of mid-2026.
| Sector / Zone | Possession Status | Can You Build Now? |
| Sector O (Model Block) | Semi-possession | Yes for buyers with full payment complete |
| Sectors P, Q, R, S, T (Model Block) | Active development | No infrastructure still in progress |
| N Block | Early development | No launched September 2025 |
| Overseas Enclave | Infrastructure underway | No not yet possession-ready |
| General Blocks (A, F, I, J, K, L, Y, X) | Varied mostly early to mid stage | No confirm per sector with sales team |
| Education City | Planning and early groundwork | No |
| Silicon Oasis | Planning stage | No |
Sector O The Only Sector at Semi-Possession Right Now
Sector O is the most developed residential zone in all of Faisal Town Phase 2. Roads are carpeted, green belts are planted, and underground utility work is either complete or in its final stages. Buyers who have completed their full payment can begin construction now no further waiting for infrastructure to be laid around them. This is what makes Sector O genuinely different from every other part of the project. It’s the only place in FT2 where the transition from buying a plot to building a home is currently possible.
Model Block Sectors P, Q, R, S, T Active Development, Not Yet at Possession
Sectors P, Q, R, S, and T are actively developing within the Model Block but haven’t reached Sector O’s stage yet. Roads are being cut, infrastructure work is progressing, and plot demarcation is underway across these sectors. The Chairman’s stated target of 1 to 1.5 years for Model Block possession applies to this cluster but that’s a target, not a confirmed date. Buyers in these sectors should track progress directly with the sales office rather than relying on any fixed timeline from any published source.
N Block Launched September 2025, Earliest Stage
N Block was launched in September 2025 making it one of the most recently added general blocks to the active booking list. Given its late 2025 launch date, it is at one of the earlier development stages among the named sectors in Faisal Town Phase 2. Land levelling and groundwork are underway, but possession for N Block buyers is further out than for Model Block buyers. Buyers who booked here based on the 365-foot boulevard and CBD adjacency are in a longer-hold position by nature of when the sector launched.
Overseas Enclave Infrastructure Underway, Not Yet Possession-Ready
The Overseas Enclave is one of the more actively developing zones outside the Model Block, with land levelling substantially complete and infrastructure work progressing across the nine sub-sectors. That said, it has not reached possession stage buyers cannot begin construction yet. For overseas Pakistani buyers who booked here specifically for the dedicated community and monthly installment structure, the current status means their plot exists on the ground and is being developed, but the wait before building is still ongoing.
General Blocks (A, F, I, J, K, L, Y, X) Varied Progress, Longer Wait
General blocks across Faisal Town Phase 2 are at different development stages depending on their position in the master plan and when they were launched or opened for booking. Sector A and Sector K are among the more progressed general blocks roads are finished in both. Sectors I, J, and Y have groundwork complete with roads under construction. Sectors L and F are at similar stages. Sector X sits alongside the Ring Road corridor with its own development dynamic. None of these sectors is at possession stage as of mid-2026. Buyers in general blocks are in the longest wait position within the project confirm the current status of your specific sector directly with the sales team since progress varies block by block.
What the Developer Has Officially Said About Timelines
Chaudhry Abdul Majeed, Chairman of Faisal Town Group, made two specific statements about timelines during a site visit that have been widely reported across multiple independent sources covering this project.
| Statement | What Was Said | Context |
| Full project completion | Less than 4 years | Announced during site visit — reflects overall FT2 development target |
| Model Block possession | 1 to 1.5 years | Specifically for Model Block sectors |
| Project vision | FT2 will be a third city beside Rawalpindi and Islamabad | Stated to audience during site visit |
Two things worth being clear about when reading these statements:
First these are targets, not guarantees. Large-scale housing society projects in Pakistan have a history of timelines shifting based on regulatory, funding, and infrastructure factors outside any developer’s full control. The Chairman’s statements reflect the company’s stated roadmap, not a contractually binding delivery date.
Second “less than 4 years” for the full project is different from when your specific sector reaches possession. The Model Block’s 1 to 1.5 year target is the most specific figure given. For general blocks and the Overseas Enclave, no specific possession timeline has been publicly stated. Treating the full project timeline as your sector’s possession timeline would be a misreading of what was actually said.
Possession vs NOC Why These Are Two Different Things
This is the distinction most competitor pages get wrong and it matters practically for buyers in Sector O right now. Sector O is at semi-possession stage, meaning buyers can begin construction. But Faisal Town Phase 2 does not have NOC approval from the Rawalpindi Development Authority as of 2026. Both of these things are true at the same time. For the full picture on what the current NOC and RDA Status means for buyers, see our dedicated page.
| Factor | Sector O Status | Rest of FT2 |
| Possession | Semi-possession construction can begin | Not yet at possession stage |
| NOC Status | Not approved same as rest of FT2 | Not approved |
| Can you build? | Yes infrastructure is in place | No development still ongoing |
| Legal approval granted? | No NOC pending regardless of possession | No |
Here’s why this matters in plain terms: possession is a developer-side milestone it means the physical infrastructure is ready enough for you to build. NOC is a government-side approval it means the Rawalpindi Development Authority has formally reviewed and approved the housing society. One doesn’t depend on the other, and one doesn’t substitute for the other. A buyer in Sector O can begin construction today without NOC approval being in place but they’re still operating within a pre-NOC legal framework that carries its own uncertainties. Verify current NOC status yourself at ahs.punjab.gov.pk before making any decision based on either status.
What Should You Do If Your Sector Hasn’t Reached Possession Yet?
Most FT2 buyers are in sectors that haven’t reached possession and that’s a normal position for a project at this stage. Here’s what actually makes sense to do while you wait rather than sitting with uncertainty.
1. Verify your payment status through the official member portal Log in through our Member Portal guide and confirm that all your installments are up to date and your account shows no outstanding dues. When your sector does reach possession, buyers with clean payment records process faster than those with gaps. Don’t wait until possession is announced to discover a dues issue.
2. Contact the sales office directly for your sector’s specific status General project updates tell you what’s happening across FT2 broadly. Your sector’s specific progress road cutting, plot demarcation, utility installation is something the sales team can update you on directly. Call 051-111-324-725 or WhatsApp +92 304 4811717 and ask specifically about your sector rather than the project overall.
3. Don’t rely on social media or dealer updates for possession announcements Possession announcements for Faisal Town Phase 2 come through official channels the developer’s own communications and the member portal. WhatsApp forwards and dealer messages are often outdated, exaggerated, or based on speculation rather than confirmed developer communication. The official member portal and direct sales office contact are the two reliable sources.
4. Plan your construction finances in advance Possession arriving and construction budget being ready are two separate things. If your sector reaches possession before you’ve arranged your construction financing, you lose the advantage of being able to build immediately. Having a rough construction cost estimate and a builder contact ready before possession is announced puts you in a better position than scrambling after the announcement.
